Workload Calculation and Color Coding

tip

Please read the article Essential settings for the workload first, so that you know which InLoox Account Settings you need to configure.

Calculation Basis

InLoox uses the following data to calculate the resource utilization:

  • Calendar of the persons
  • Effort of the task(s) of the assigned person
  • Start and end date of the task, or start and end date of the activity assigned to the task, or start and end date of the project (if the task has no start/end date and is not assigned to any activity)

Additionally, you can optionally include the following data in the workload calculation using filters:

  • Outlook appointments of people (optional)
  • Project requests (optional)
  • Completed tasks of the people (optional)

Flexible Filter Options

With the filter options, you can control the workload calculation even more precisely. Using sliders, you can specify whether project requests and Outlook appointments should be included or excluded, and which projects with specific status values (e.g. Started) should be taken into account.

Filter options in the workload

Levels in the Workload View

In the workload view itself you will find different levels:

  1. Division & team level: Here you can see the total utilization of all persons assigned to a specific division or team. You can create teams manually in the workload view, and you can create a division in the InLoox Account Settings under Organization > Divisions. Read more details under Teams and Divisions.
  2. Person level: Here you can see the total utilization of the resource (person). The intuitive level indicator helps you to see the level of workload at a glance.
  3. Project level: Here you can see the assignment of the resource to various projects as well as the total workload across the individual projects.
  4. Task level & Outlook appointments: If you are interested in detailed project information, you can further expand the projects and see the individual tasks including effort in hours for each task. Additionally, InLoox offers an extended integration with your personal Outlook account for the workload. The synchronized appointments are displayed in the workload in the line Outlook appointments. These appointments only contain information about start, end and therefore also the duration (corresponds to the effort) of the appointment. Other details like subject and description of the appointment are not relevant in the workload and will not be displayed.

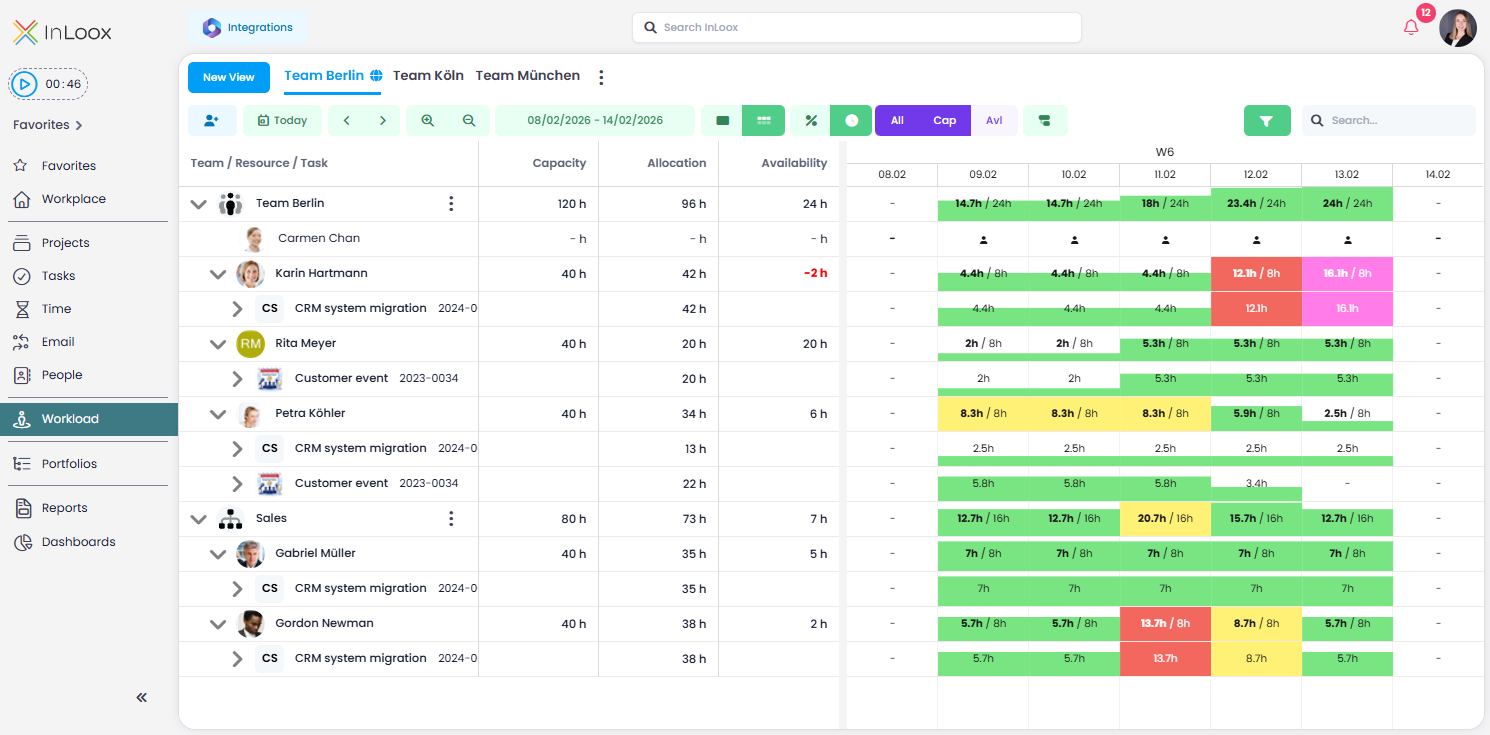

Workload view with different levels

info

The Outlook integration requires an active connection between your Microsoft 365 account and InLoox — you can set this up in the essential settings.

tip

To avoid having to expand/collapse the levels manually, use the Expand/Collapse Levels button in the navigation bar and choose between Teams & Divisions, People, Projects, or Tasks & Events. This allows you to switch to the desired level of detail for all resources at once, which is particularly helpful for larger resource planning tasks.

Columns in the Workload View

Since InLoox 26.1, the following columns are displayed by default in the workload view:

  • Capacity: Based on the selected calendar of the resource, this column shows how many working hours are generally available, e.g. 40 hours per week.
  • Allocation: Shows how many working hours are already scheduled, e.g. due to the effort required for assigned tasks or Outlook appointments.
  • Availability: Shows how many working hours are still available.

For the calendar view itself, you can set whether the utilization information should be displayed in % or in absolute values (hours). When choosing absolute values in hours, the three purple buttons for allocation, capacity, and availability can be used to make precise forecasts about how much capacity is still available in the coming months, for example. For more details about the buttons in the navigation bar, see Navigation, Details and Sharing.

Color Coding

InLoox reports working days as overbooked if the effort exceeds the working time. Based on the calendar assigned to the resource, days are color-coded as follows:

  • Green — Capacity available, allocation under or at 100%
  • Yellow — Allocation between 101–150%
  • Red — Allocation between 151–199%
  • Pink — Allocation at or above 200%

The effort of the assigned tasks is distributed linearly to the working days in the period according to the time frame that InLoox calculates either from the start/end date of the task, the assigned activity, or the project.

Example

The task "Create presentation" has an effort of 5 hours. The start date is today at 2:00 PM and the end date is tomorrow at 11:00 AM. InLoox distributes the effort evenly, allocating 2.5 hours to today and 2.5 hours to tomorrow. Since the working time calendar defines working hours from 8:00 AM to 4:00 PM, today is booked at 37.5% and the following day is also booked at 37.5%. There is still capacity available on both days. The resource can take on additional tasks with a total effort of up to 5.5 hours before reaching 100% capacity.

Display of Absences

InLoox can display and highlight absences in the workload overview with an icon.

In order for that to work, you need to add work-free days to calendars or individual people in the InLoox settings. Read the help article on defining working hours, calendars and days off for more details.
